Dynamic due dates allow you to configure tasks to be due based on a dynamic action or event. For example, you can configure Task 2 to be due 1 hour after Task 1 is completed.


TABLE OF CONTENTS


Date input from previous Task

This type of Dynamic Due Date is triggered from a date that's input into another task.

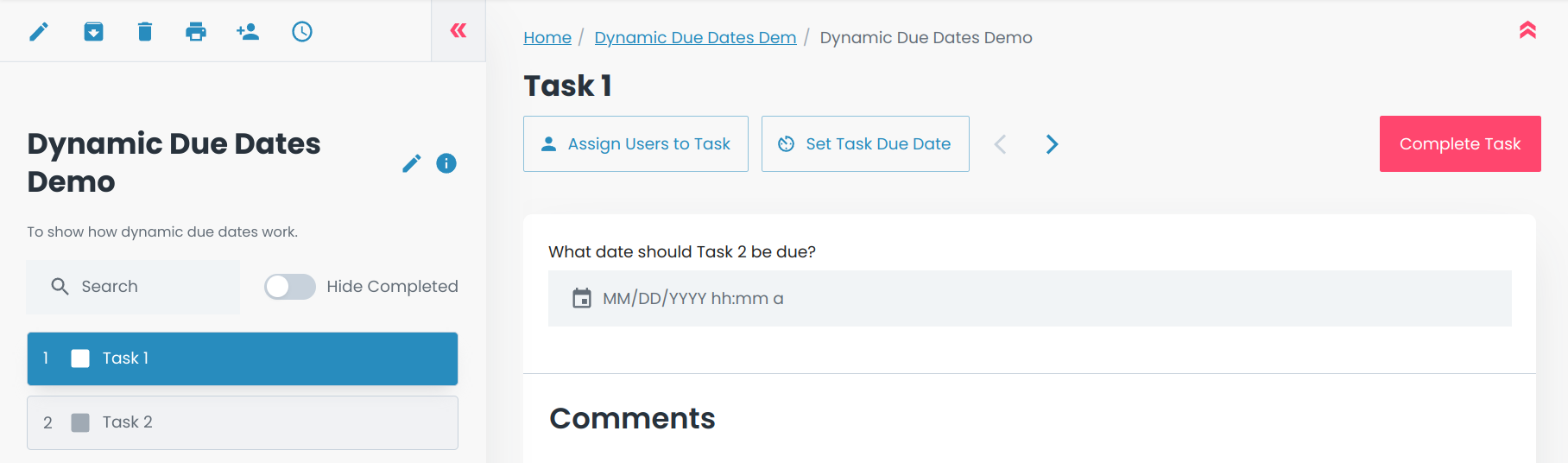

First, we add a Request Date section to Task 1:

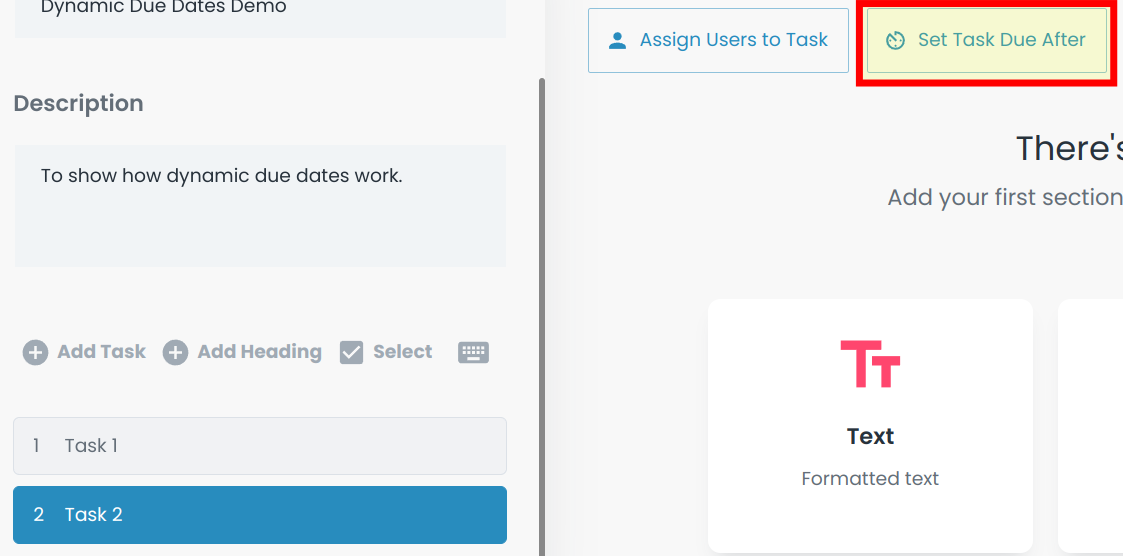

Then, in Task 2, click the Set Task Due After button:


This dialog opens and we configure its fields:


Trigger: A date input section from a specific task

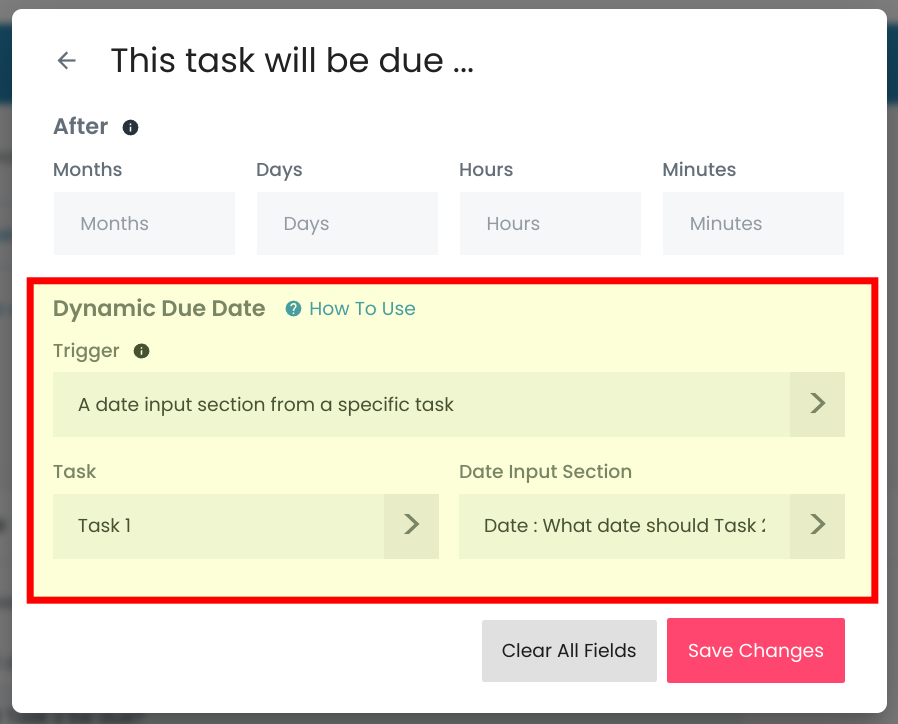

Task: Task 1 (where the date input section is)

Date Input Section: Date: What date should Task 2 be due (the label for the section we added in Task 1)


Then, we create a workflow from this template:

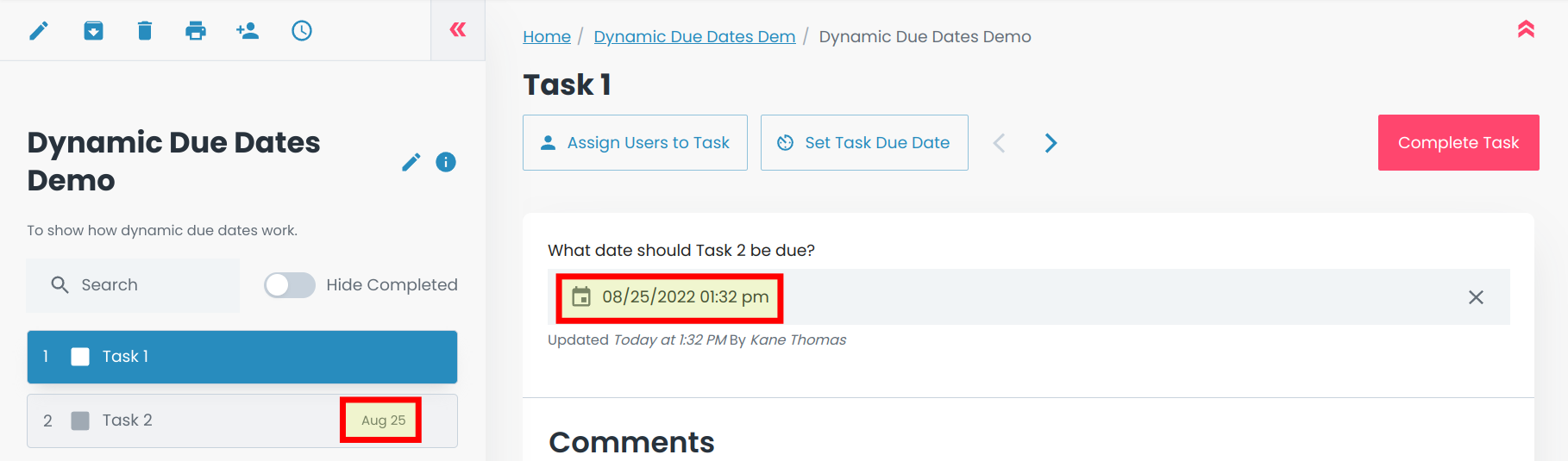

Finally, after choosing a date in the Date Request section in Task 1, we can see that Task 2 is automatically assigned this due date:


Completion of a previous Task

This type of Dynamic Due Date is triggered from the completion of another task.


First, in Task 2, we click the Set Task Due After button:

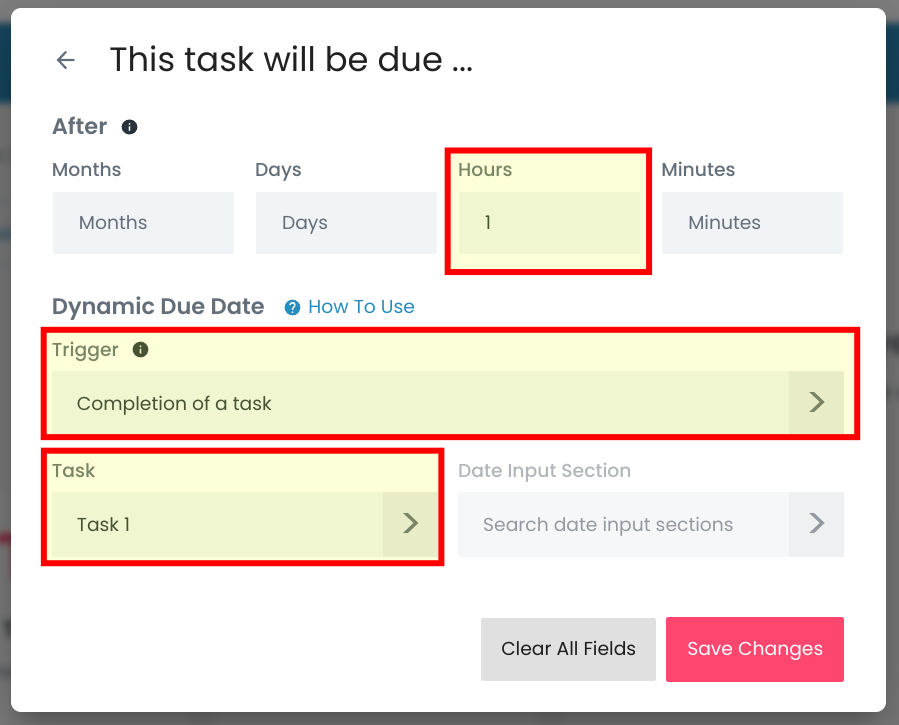

Next, we set:


Trigger: Completion of a task

Task: Task 1

After 1 Hour: this means Task 2 will be due 1 hour after Task 1 is complete

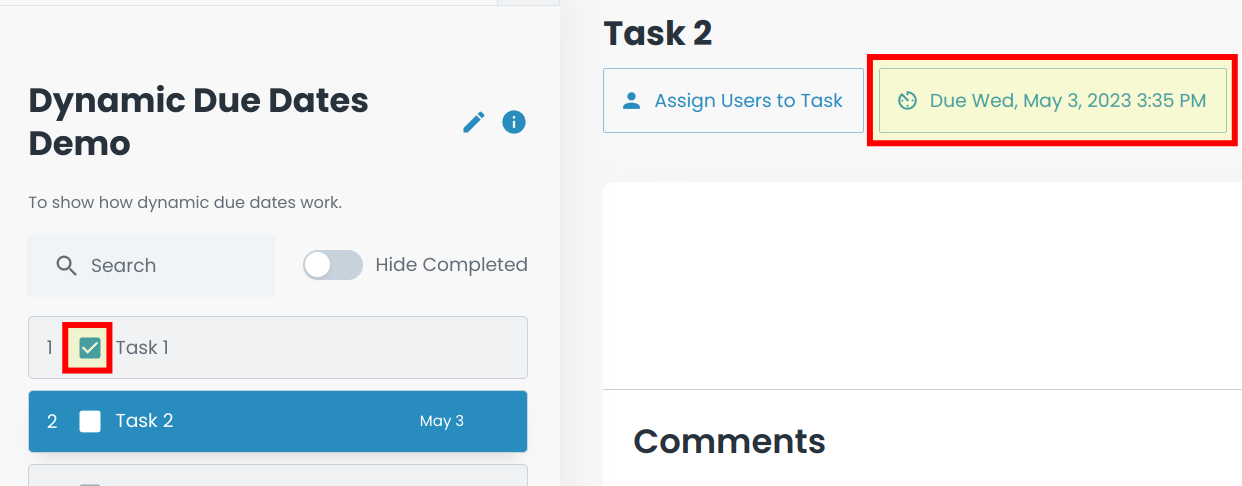

Then we create a workflow from this template, and complete Task 1. And immediately after Task 1 is completed, Task 2 has a due date set of 1 hour later:

(in this example, Task 1 was completed at 2:35 PM)


Before Workflow's Due Date

This type of Dynamic Due Date is triggered when a workflow's due date is set.

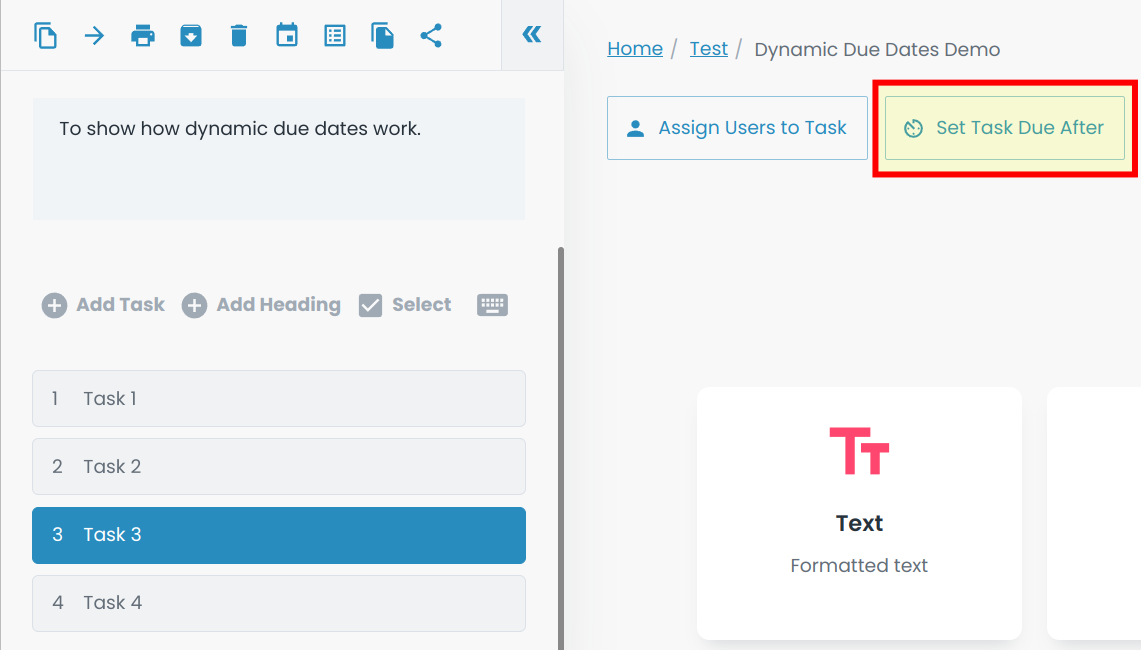

First, in Task 3, we click the Set Task Due After button:


Next, we set:

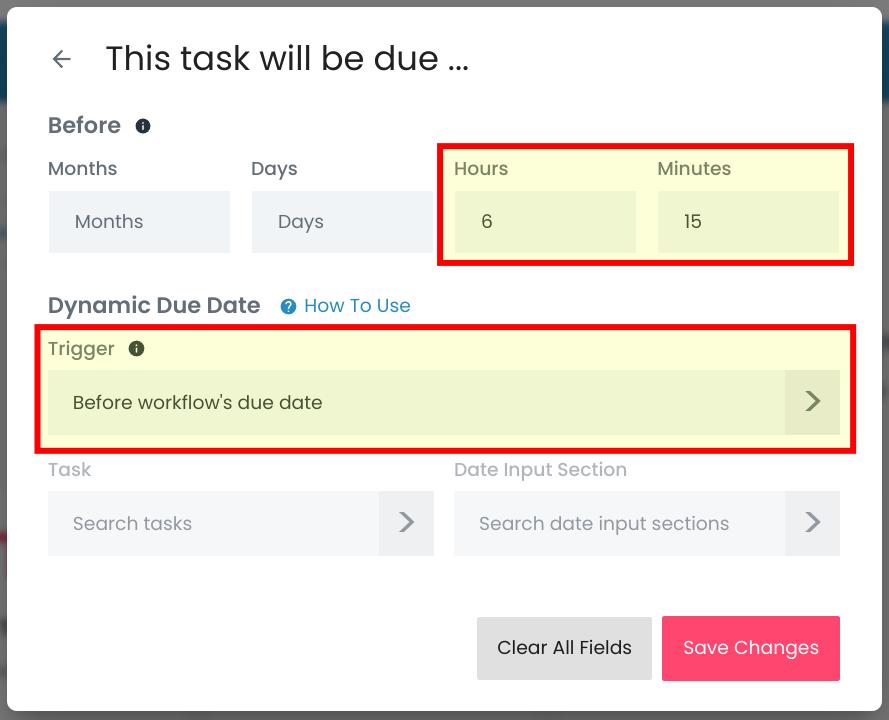

Trigger: Before workflow's due date

Before 6 Hours, 15 Minutes: this means Task 3 will be due 6 hours and 15 minutes before the workflow's due date


Then we create a workflow from this template, and set the workflow's due date to June 1 at 12:00 PM. And then we observe that Task 3 is now due June 1 at 5:45 AM (as expected):


After Workflow's Due Date

This type of Dynamic Due Date is triggered when a workflow's due date is set.

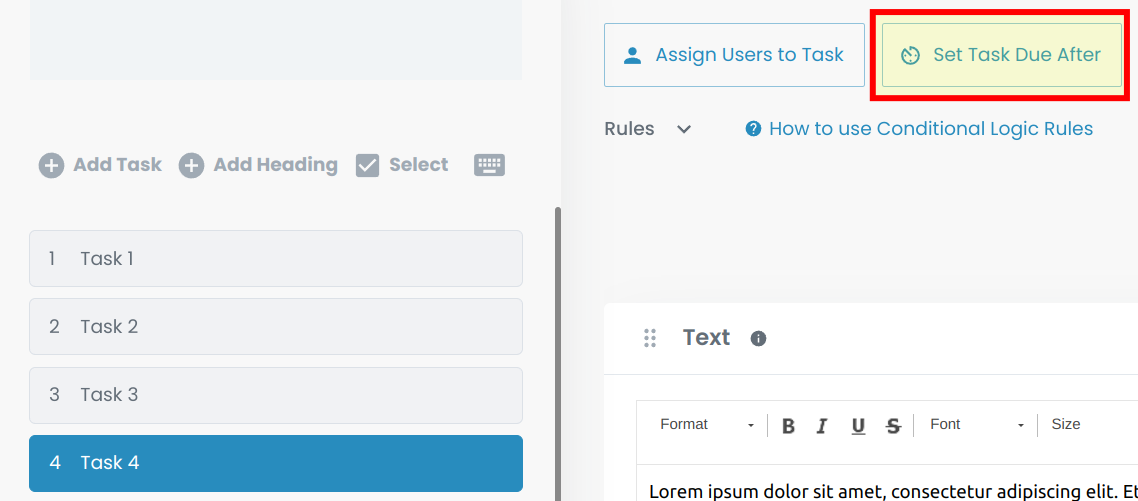

First, in Task 4, we click the Set Task Due After button:


Next, we set:


Trigger: After workflow's due date

After 5 Minutes: this means Task 4 will be due 5 minutes after the workflow's due date

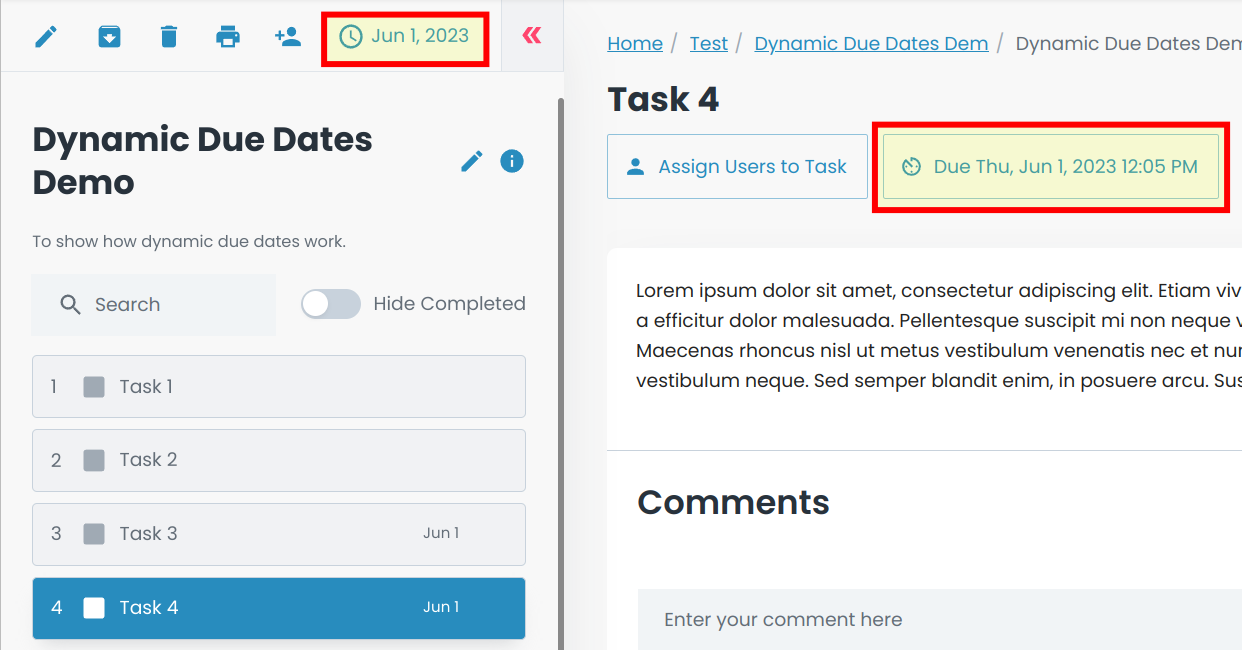

Then we create a workflow from this template, and set the workflow's due date to June 1 at 12:00 PM. And then we observe that Task 4 is now due June 1 at 12:05 PM (as expected):


After Workflow's Created Date

This type of Dynamic Due Date is triggered when a workflow is created.

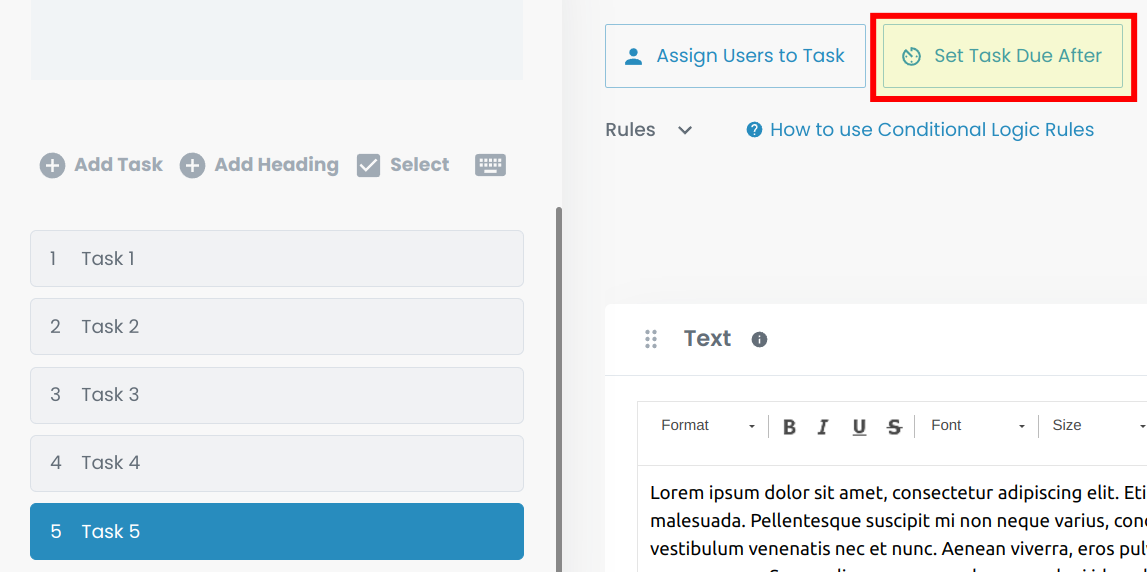

First, in Task 5, we click the Set Task Due After button:


Next, we set:

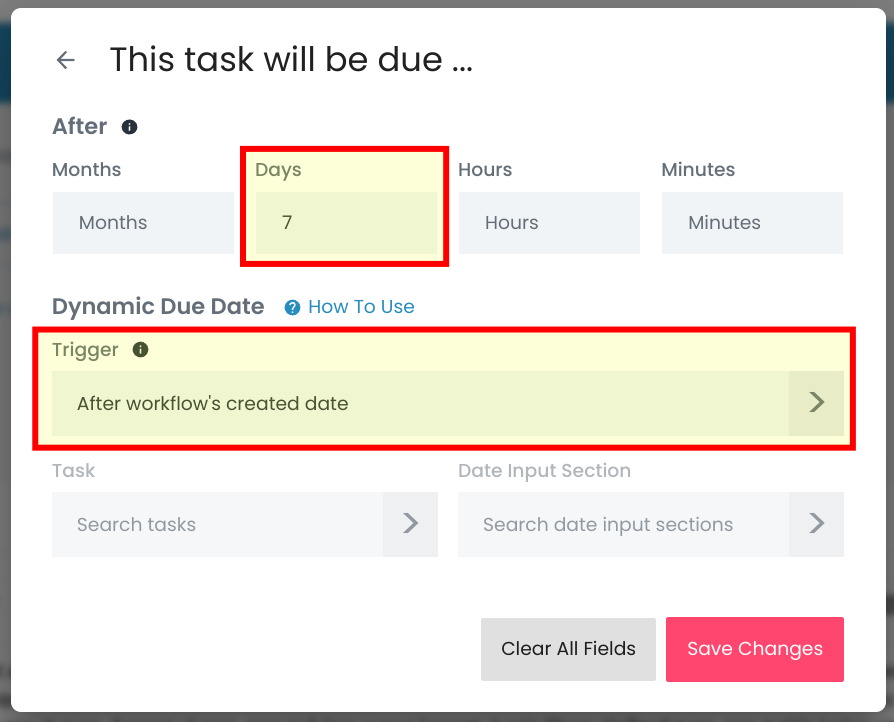

Trigger: After workflow's created date

After 7 Days: this means Task 5 will be due 7 days after the workflow is created

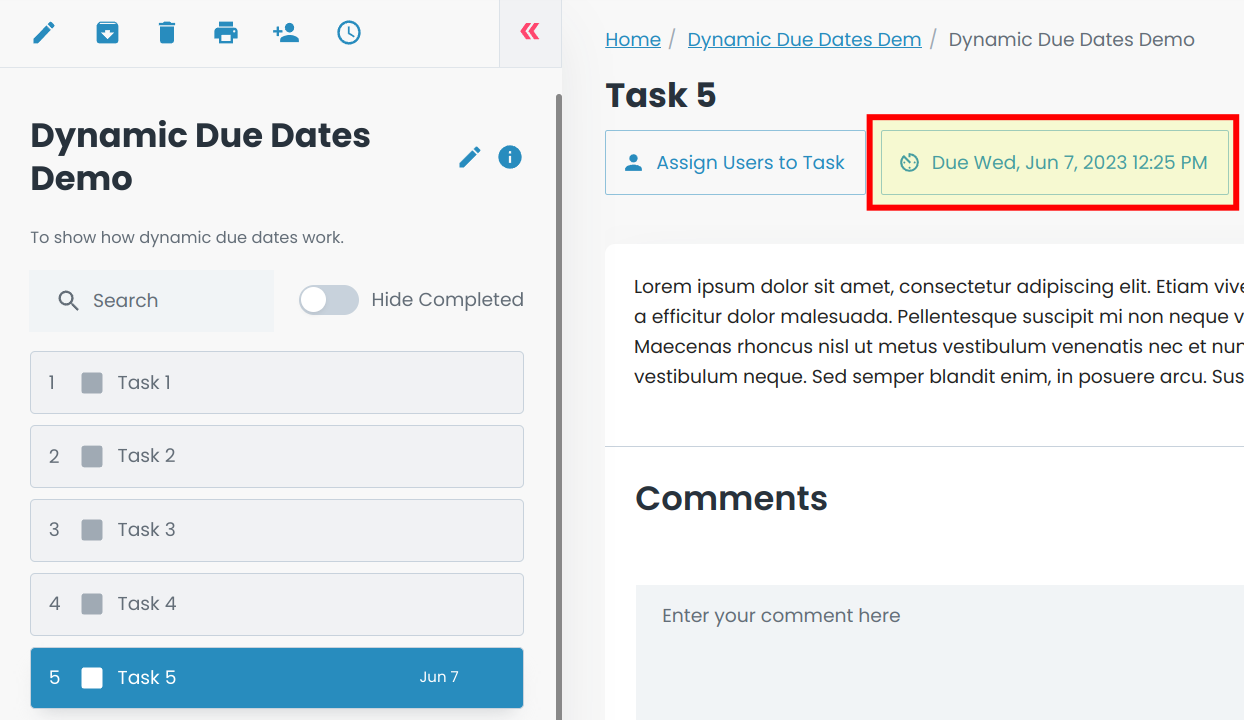

Then we create a workflow from this template (the time we created it was May 31 at 12:25 PM), and then we observe that Task 5 is now due June 7 at 12:25 PM (as expected):
